Snagging list, site diary and other site paperwork templates

Last checked 4 October 2026

Four free templates in Word and PDF, with no email needed: a snagging list with a photo reference column, a site diary, a monthly progress report and a variation order. With each one: what it's for and what goes in it.

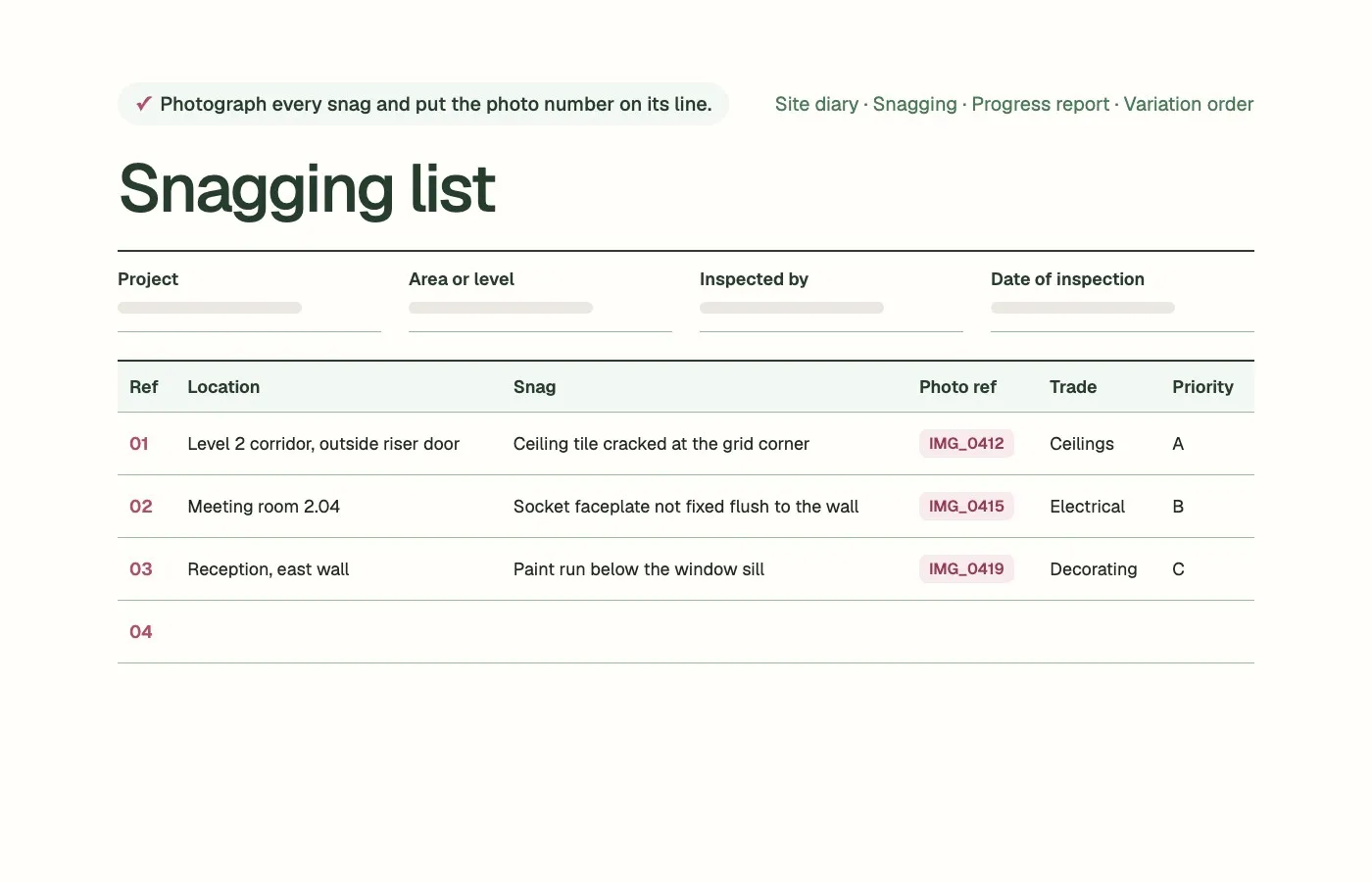

The snagging list template with three example snags, each with a location, a description, a photo reference, a trade and a priority

The paperwork that keeps a job on track and gets you paid, in a layout your team can fill in on site. Each template is written out below, as well as in the files.

  1. Snagging list

    With a photo reference column, on a landscape page

    Word file of the snagging listPDF of the snagging list

  2. Site diary

    Labour, work done, deliveries, instructions and delays

    Word file of the site diaryPDF of the site diary

  3. Monthly progress report

    Programme, key dates, safety, payment, risks and next month

    Word file of the monthly progress reportPDF of the monthly progress report

  4. Variation order

    The change, the reason, the cost and the time, signed by both sides

    Word file of the variation orderPDF of the variation order

What is a snagging list?

A snagging list, or snag list, records the defects and unfinished items found when work is inspected, usually as a job nears handover. Each line says where the snag is, what's wrong, who will fix it and by when, so nothing gets missed and the client can sign the work off.

Clearing snags quickly helps your cash too. The government's 2017 consultation on retention described the usual practice as releasing half the retention at completion and the rest after the defects period, so an open snag list can hold up money you're owed.

A good snag takes six things:

  1. Say exactly where it is: level, room, wall or gridline.

  2. Describe what's wrong, not just the item.

  3. Photograph it and put the photo number on the line.

  4. Name the trade that will fix it.

  5. Give it a priority and a target date.

  6. Sign it off once it's fixed and checked.

Snagging list

Photograph every snag and put the photo number on its line.

Project
Area or level
Inspected by
Date of inspection
Contractor or trade
Handover date

One line per snag. Say exactly where it is, so whoever fixes it can find it without asking.

RefLocationSnagPhoto refTradePriorityTarget dateFixed (date, initials)Checked by

Priority: A, fix before handover. B, fix by the agreed date. C, minor or cosmetic. The Word file has room for 10 snags on a landscape page.

Snags closed out

NameSignatureDate
Contractor
Client or representative

Free to use and change. Check it against your own site before use.

What goes in a site diary?

A site diary is the daily record of what happened on site: who was there, the weather, the work done, deliveries, visitors, instructions received, and any delays or problems with the hours lost. Written up on the day, it's the record you'll reach for when someone later asks what happened and when.

Keep it short and factual. If an instruction is given to you on site, note it in the diary and confirm it in writing the same day.

Site diary

Fill it in on the day, and sign it before you leave site.

Project
Site address
Date
Completed by
Weather, morning
Weather, afternoon
Site hours
Page
  1. 01Labour on site

    Every company on site today, the trade and how many people.

    CompanyTradeNumberWorking on
  2. 02Work done today

    By area or level. Say what was finished, not just what was worked on.

    Area or levelWork doneFinished?
  3. 03Plant and deliveries

    Plant on site and what arrived. Note anything short, late or damaged.

    Plant or deliverySupplierNote
  4. 04Visitors and inspections

    NameCompanyReason for visit
  5. 05Instructions received

    Any instruction from the client, designer or main contractor, and who gave it. Confirm spoken instructions in writing.

    FromInstructionReference
  6. 06Delays and problems

    What happened, when, and what it held up. Note the hours lost.

    What happenedWork affectedHours lost
  7. 07Health and safety

    Accidents, near misses, toolbox talks held, and any work you stopped.

  8. 08Photos taken

    Photo numbers and what they show, so you can find them later.

Signed

NameSignatureDate

Free to use and change. Check it against your own site before use.

What does a construction progress report cover?

A monthly progress report tells the client where the job stands: progress against the programme, key dates and any change to them, health and safety, labour, information you're waiting for, variations, payment, risks and next month's work. Keep the same headings every month so changes stand out.

Monthly progress report

Send it on the same day each month, under the same headings.

Project
Client
Report number
Period covered
Prepared by
Date issued
  1. 01Summary

    Three or four lines: where the job stands, what changed this month and anything the client needs to decide.

  2. 02Progress against the programme

    Status is on track, behind or ahead. Say why for anything behind.

    Stage or activityPlanned % completeActual % completeStatusComment
  3. 03Key dates

    MilestoneContract dateForecast dateChange in days
  4. 04Health and safety

    This monthTo dateNotes
    Accidents
    Near misses
    Inspections
    Toolbox talks held
  5. 05Labour and resources

    Average numbers on site by trade, and any shortfall.

  6. 06Information needed

    Open questions and design information, with the date you need an answer.

    Question or requestDate askedNeeded byFrom
  7. 07Variations and instructions

    RefDescriptionStatusValue, if agreed
  8. 08Valuations and payment

    ApplicationAmount applied forAmount certifiedDate paid
  9. 09Risks and issues

    IssueEffectActionOwner
  10. 10Next month

    The work planned for next month, and any access or information you need for it.

  11. 11Photos

    Photo numbers with a caption each. Put the photos at the end of the report.

Free to use and change. Check it against your own site before use.

What is a variation order?

A variation order records a change to the work you were contracted to do: what's changing, why, who instructed it, and its effect on cost and programme. Getting it agreed in writing before the work starts protects your payment, because a change nobody signed for is harder to get paid for later.

Your contract decides who can instruct a change, how it's valued and any time limit for telling the other side, so check those clauses and use your contract's own terms on the form.

Variation order

Check your contract for who can instruct a change and any notice period.

Project
Contract
Variation number
Date raised
Raised by
Instruction reference
  1. 01What is changing

    Describe the change against the original scope. Attach drawings or marked-up photos.

  2. 02Why

    Who asked for it and why: a client request, a design change or something found on site.

  3. 03Drawings and documents affected

    Drawing or documentRevisionNote
  4. 04Effect on the programme

    Extra working daysActivities affectedEffect on the completion date
  5. 05Cost of the change

    Say how it's valued: contract rates, a quotation or daywork.

    DescriptionAmount (£)
    Labour
    Materials
    Plant
    Subcontract
    Preliminaries
    Overheads and profit
    Total

Agreed

Both sign before the work starts, or record why it started first.

NamePositionSignatureDate
Contractor
Client or contract administrator

Free to use and change. Check it against your own site before use.

How do you keep site paperwork under control?

Document control means everyone works from the latest version and can find any record later. For site paperwork, that comes down to one place to keep it, a numbering system, a revision on every document, and a log of what was issued to whom and when.

  1. Keep each job's paperwork in one shared place, with the same folders on every job.

  2. Number everything: snags, variations, reports and photos, so one document can point to another.

  3. Put a revision and a date on every document.

  4. Keep an issue log of what went to whom, and when.

  5. File the day's paperwork the same day.

If you use Microsoft 365, keeping site records in SharePoint or Teams also puts them where Copilot can find them, for the people allowed to open them. The guide to using AI with the systems you already run explains what to check first.

Where can AI help with site paperwork?

AI saves the most time on the write-up. From the photos and voice notes taken on a walk-round, it can draft the snagging list with locations and trades filled in. From a month of site diary entries, it can draft the progress report's summary, delays and look-ahead. A person checks every line before it goes out.

What you send

Voice note: “Level two corridor, just outside the riser door. Ceiling tile's cracked at the corner of the grid. One for the ceiling fixers, before handover.”

What AI drafts

Example

Ref
01
Location
Level 2 corridor, outside riser door
Snag
Ceiling tile cracked at the grid corner
Photo ref
IMG_0412
Trade
Ceilings
Priority
A

The site manager checks the line against the photo before it goes on the list.

An example: a photo number and a voice note from a walk-round, and the snag line AI drafts from them for a person to check.

Give it

  • Photos, with their numbers
  • Voice notes or quick notes from the walk-round
  • The drawing or room list for the area
  • This month's site diary entries

Always check

  • Every location and description against its photo
  • The trade and priority on each snag
  • Dates and figures in the progress report
  • Anything that reads like a contract position, before it goes to the client

Before your team puts site photos and reports into AI, agree what can go in. The AI policy template covers it in two pages.

More free templates

A toolbox talk template with topic, key points and an attendance table

Toolbox talk

One page with a record of who attended, plus five starter talks
